Access road construction NSW builds permanent site access: formation, pavement layers, and drainage sequenced as one corridor that carries construction traffic first and design-life traffic after. Asphalt over soft shoulders or unfinished drains is not a finished road—agree hold points before plant commits the alignment.

Send Project DetailsAll guides
In this blog

Why access road construction NSW needs a formation-first sequence

Most access road construction NSW programmes lose time after pavement starts—not before. Soft formation, incomplete table drains, or ambiguous layer specs force the pavement crew to stop, reshape, or rebuild after traffic has already damaged the corridor.

Treat the road as a construction asset first and an operational route second. Formation width, crown, turning, and drainage at low points must be proven before sealed or unbound layers lock moisture into a weak subgrade.

NEXTGEN delivers these corridors through its road construction contractor NSW team, coordinating civil interfaces so earthworks and pavement crews are not working to different assumptions on the same alignment. This guide supports that hub with access-road process depth.

This guide covers permanent access roads: corridors built for their design life, sealed or unbound to specification, tied to the public road, and kept for operations and O&M traffic. Routes that only last for the works programme are covered in temporary haul road construction. Solar and battery sites that need both are covered in renewable energy access roads.

Step 1 — Lock formation geometry and construction traffic loads

Confirm design speed is not the only driver. Construction vehicles, imported fill trucks, and later O&M traffic often exceed the lighter loads assumed for a finished access track. Width, curve radii, and passing bays should match the heaviest temporary plant.

Set survey control for centreline, edge levels, and crown early. Formation without reliable level control creates thin spots that fail under the first week of haul traffic—even when the surface looks neat.

Document where temporary tracks end and permanent access begins. Mixing both roles on one unfinished surface is a common reason access road construction NSW packages need mid-project repairs.

Step 2 — Appoint drainage hold points before pavement layers

The drainage crew should own pits, culverts, table drains, and outlet protection relative to formation levels—not as a cleanup after sealing. Water that sits in the pavement box softens subgrades faster than most programmes recover.

Require a mark-up that shows when drains are open, when temporary diversions are allowed, and who reinstates shoulders after pipe installation. Orphan interfaces at kerbs, headwalls, and fence crossings are where pavement edges unravel.

Where the corridor ties into broader site drains or utility trenches, keep civil sequencing visible with NEXTGEN’s civil infrastructure team so road and site packages share one water path story.

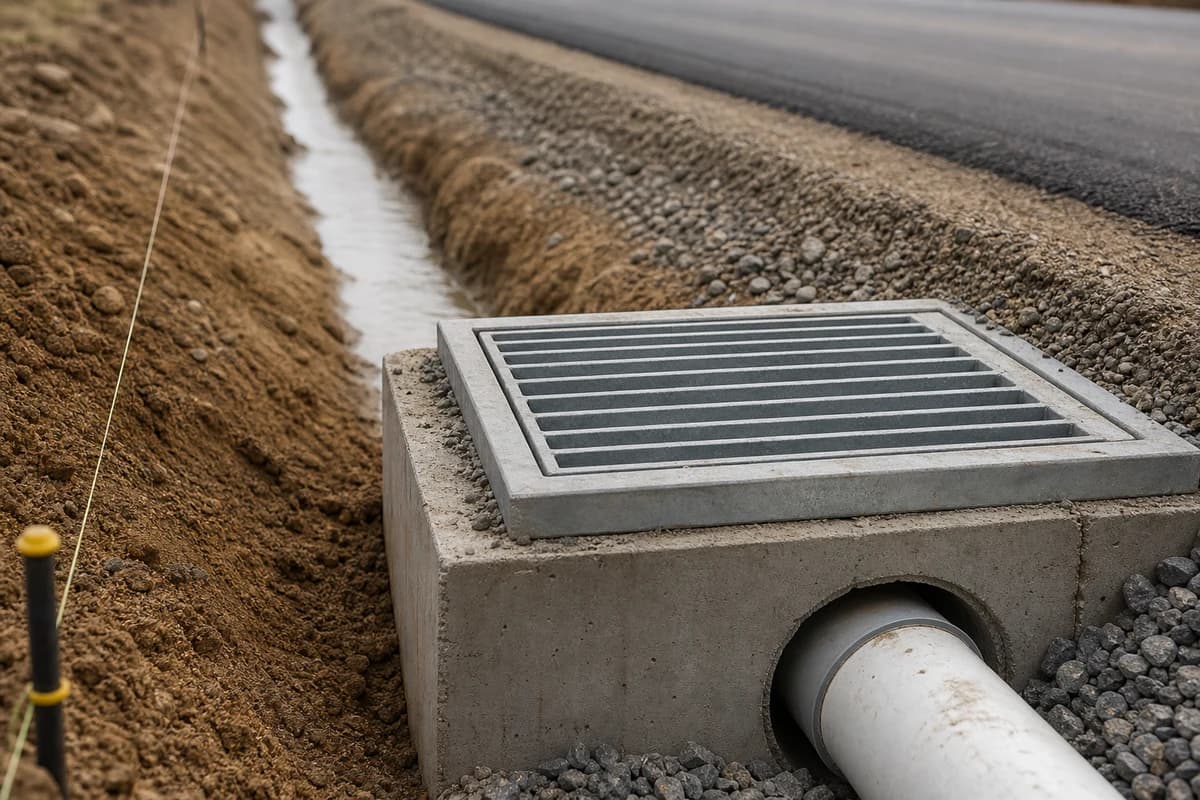

Drainage crew setting a grated pit and table drain beside a compacted NSW access road shoulder
Drainage levels and outlets should be proven before pavement layers close the corridor.

Step 3 — Build pavement layers the contractor can prove

The access road contractor should state material specs, compaction criteria, and proof methods for each unbound or bound layer. “Compacted gravel” without moisture, density, and thickness checks is not a quality plan.

Match layer design to subgrade strength after wet weather—not only to a dry tender assumption. Many NSW sites need micro adjustments to thickness or material once formation moisture is measured on the alignment.

Review comparable corridor delivery through NEXTGEN’s project showcase when you evaluate whether the method covers heavy construction traffic as well as final use.

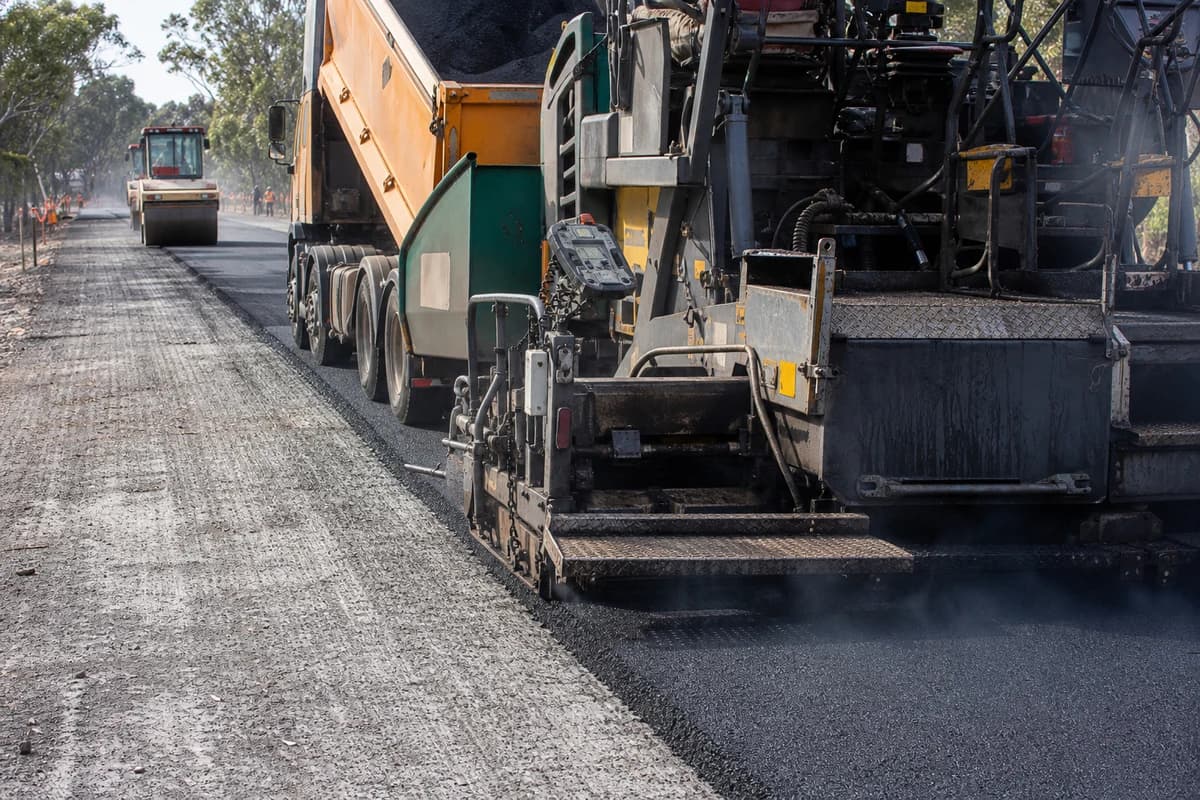

Paver and roller placing asphalt over the base course of a permanent NSW access road
Asphalt and unbound layers only protect the route when formation and drainage holds are already closed.

Step 4 — Plan asphalt around moisture and interface edges

Asphalt on access roads fails at edges and joints when shoulders, drains, or temporary crossings are still unfinished. Freeze the pavement edge detail with the drainage and fence package before the paver arrives.

Confirm weather windows, temperature limits, and traffic control if the road touches a public interface. Access roads often sit partly on private land and partly at a public road intersection—each zone needs a different traffic-aware method.

Where a sealed layer is deferred, define an interim trafficable surface and who maintains it. Leaving formation open to haul trucks without a written interim plan usually becomes an unowned defect conversation.

If the corridor already shows rutting or edge failure, when road rehabilitation is needed beyond resurfacing helps owners decide whether formation must be rebuilt before new pavement layers.

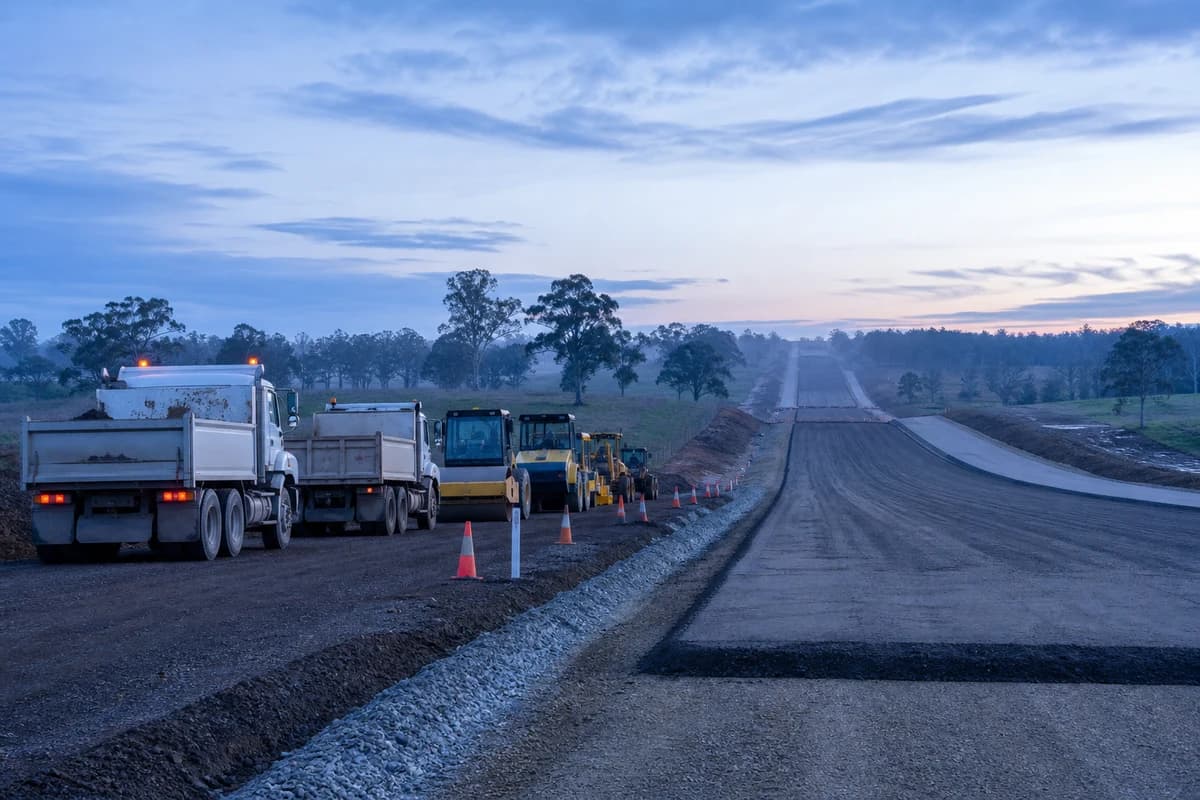

Access road construction NSW plant fleet beside unfinished pavement layers in cool morning light
Construction traffic loads should be named when pavement interim surfaces and final seals are staged.

When should an access road use asphalt?

Use asphalt on an access road when traffic is frequent or permanent, dust or mud control matters for neighbours or O&M, wet-weather reliability is critical, or the route will carry public or client vehicles rather than short-term construction plant alone. Unbound gravel or stabilised formation can be enough for temporary haul during construction if loads, maintenance ownership, and dust are named in the brief.

Asphalt does not fix weak formation or blocked drainage. If the base pumps after rain, seal the decision only after formation and outlet holds are closed—or you will mill a new surface that fails the same way.

Layer proof and pavement QC themes sit in pavement construction contractor NSW guidance; use that when the access road is permanent industrial pavement rather than a temporary track.

Quality and interface checklist before you close the package

Use this short gate before practical completion claims:

Formation surveys, compaction records, and drainage as-builts are available for the same chainage as the pavement layers.

Drainage outlets discharge to an agreed path without ponding against the pavement edge.

Asphalt joints, tie-ins, and shoulder seals match the mark-up used by the pavement crew—not a verbal variation.

Owners comparing general civil appointment criteria can also read what project owners should look for in a NSW civil contractor, then overlay road-specific drainage and layer proof questions.

If the corridor serves a renewable site, align haul and O&M needs with renewable energy access roads NSW, keep temporary tipper depth on construction haul roads, and review array packaging on solar farm civil works NSW: earthworks, access and drainage plus live array-access context on Blind Creek Solar Farm.

Brief NEXTGEN on an NSW access road package

Share alignment drawings, geotech notes, design traffic, public road interfaces, and drainage intent when you contact NEXTGEN. A clear brief lets formation, pavement, and drainage hold points be reviewed as one access road construction NSW scope.

For engagement and assurance expectations before mobilisation, use NEXTGEN’s delivery FAQ and bring the same questions into kick-off with your pavement and drainage leads.

FAQ

Frequently asked questions

What should access road construction NSW scopes include?

Include survey-controlled formation, construction and final traffic assumptions, pavement layer design with proof methods, drainage pits or table drains, and clear temporary versus permanent surface roles. Sealing alone is not a complete access package.

When should an access road use asphalt?

Use asphalt when traffic is frequent or permanent, dust or mud control matters, wet-weather reliability is critical, or public/client vehicles will use the route. Unbound surfaces can suit temporary haul if loads, maintenance, and dust ownership are named—and formation plus drainage are already sound.

What makes an access road permanent rather than temporary?

A permanent access road is designed for its full service life: pavement thickness for years of design vehicles, drainage and culverts sized for the catchment, an approved public-road tie-in, and a surface the operator can maintain. A temporary haul road is designed for the works programme only, then maintained, upgraded, or removed when construction ends.

When should drainage be built relative to pavement?

Drainage hold points should land before pavement layers close the box. The drainage crew needs agreed levels, outlets, and shoulder reinstatement so water does not soften the subgrade after compaction.

What should owners ask an access road contractor NSW before award?

Ask for material specifications, compaction and thickness proof, weather and moisture hold points, edge details at drains, and how construction traffic will use interim surfaces before asphalt or final unbound layers are finished—and who maintains those surfaces until handover.

How do asphalt interfaces go wrong on access roads?

They usually fail at edges, joints, and public road ties when drainage, shoulders, or temporary crossings are unfinished. Freeze those interfaces on a mark-up before the paver arrives.
