Stormwater Drainage Contractor NSW: Catchments, Sequencing and Handover

Before appointing a stormwater drainage contractor in NSW, confirm catchments, temporary diversions, trench sequencing, compaction at crossings and the records required for handover.

Send Project DetailsAll guides
In this blog

What to confirm before appointing a stormwater drainage contractor NSW

Ask the stormwater contractor to confirm catchments, design surface levels, temporary diversions and responsibility for pavement or pad interfaces after pipework is buried. Include outlet levels and agreed inspection records in the brief.

Sequence pits, pipes, outlets and overland flow paths with earthworks and utility crossings. Unresolved levels or temporary drainage can leave water against new hardstand; review the design, construction records and site conditions before assigning a cause.

This guide covers pit-and-pipe networks and site water: catchments, diversions, trenches, outlets, and records. A stormwater contractor NSW owners appoint for those works is not automatically the right team for road crossings—barrels, headwalls, and scour protection sit in the culverts and headwalls guide, and hardstand yards with dock aprons sit in the industrial drainage guide for yards.

Owners who want one package across earthworks, stormwater, culverts, and utilities can brief NEXTGEN's civil drainage contractor NSW team and test those answers early—before earthworks close options for pits and overland flow.

Catchments, temporary diversions, and environmental controls

Stormwater drainage NSW packages fail when the finished network is clear on drawings but temporary flow during earthworks is left improvisational. Confirm where water goes while trenches are open, and how sediment controls stay with each workfront.

Name the receiving point for each outlet—council asset, natural watercourse, or on-site basin—and who verifies levels on site. Mismatched outlet levels create ponding against pavements that looked complete at handover.

Environmental controls are not optional add-ons on NSW industrial and precinct sites. Sediment fences, dirty-water pathways, and spill response need to move with the trench—especially when overland flow paths run beside live operations or public roads.

  • Temporary diversions named for each earthworks stage—not only the final network.
  • Sediment and erosion controls relocated when the workfront moves.
  • Outlet ownership and invert checks written before backfill.
  • Design revision control so pit lids and grate types do not drift after a wet week.

Construction sequencing with earthworks and pavement edges

Stormwater construction NSW programmes work when stormwater pipe installation NSW crews land trenches and pits before pavement layers or hardstand edges close the corridor. Cutting finished drains to place late utilities—or leaving soft backfill under future pavement—reopens the surface for months.

Stormwater pits need survey control tied to finished pavement levels. A pit set high relative to the seal traps water at the edge; a pit set low without a defined shoulder transition pumps under truck traffic.

Align corridor edges with pavement construction contractor NSW and interface lessons in asphalt works and drainage interfaces when sealed spines are in the same programme.

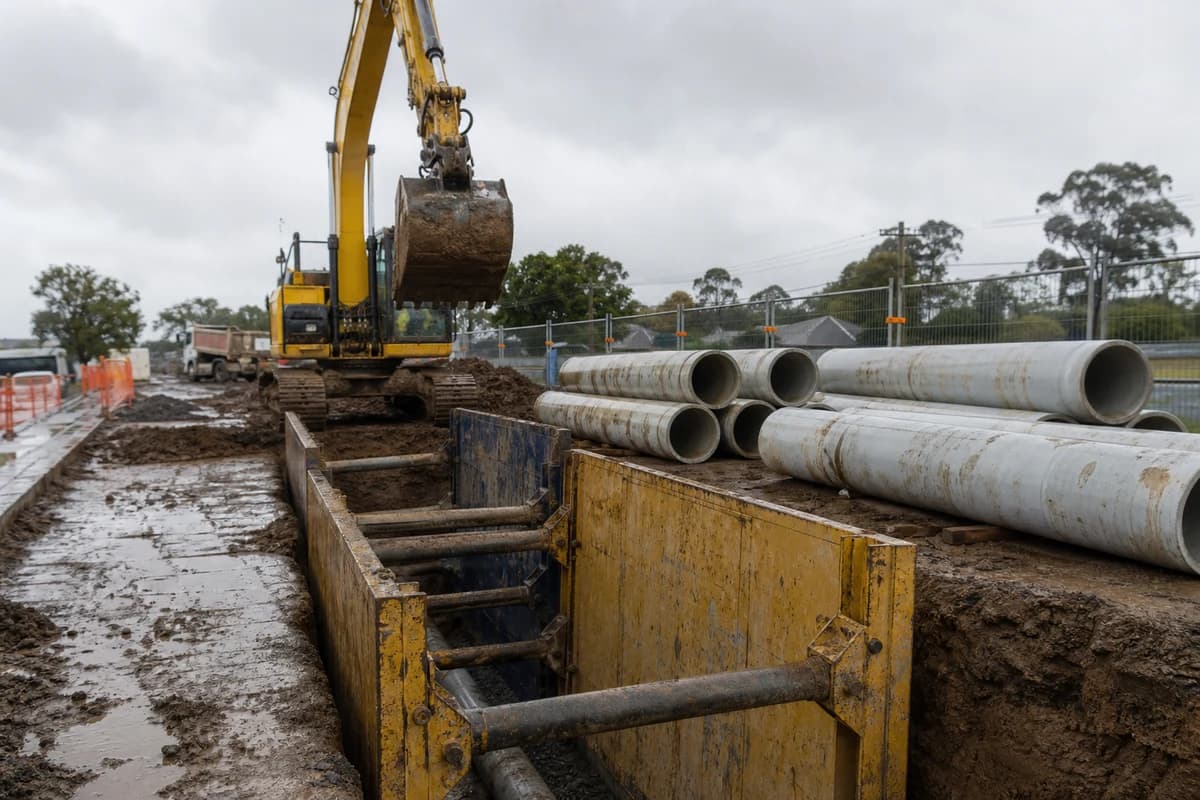

Stormwater drainage contractor NSW utility trench with excavator, shoring, and stacked pipe in wet conditions
Trench sequencing and backfill quality decide whether drainage and pavement interfaces survive the first wet season.

Utility clearances, crossing hand-offs, and live-service holds

Utility clearances matter when stormwater shares verges with water, sewer, power, or communications. Confirm horizontal and vertical separations, bedding rules at crossings, and how discoveries of undocumented services escalate.

Where the pipe network meets a road or watercourse crossing, write the hand-off point into the drawings: which pit or outlet the stormwater package finishes at, and where the culvert structure starts. Levels that do not match at that line are where ponding and scour begin.

Corridor dig method sits in utility trenching contractor NSW. Barrel, headwall, and scour detail lives in culvert installation NSW. Live industrial corridors should also review live services civil works NSW.

Inspection hold points and compaction testing before backfill

Do not approve backfill on verbal assurance. Hold points should freeze the trench until invert, bedding, jointing, and clearances are proven—and compaction testing at crossings should match the pavement or hardstand specification above.

  • Invert and alignment hold before surround and backfill.
  • Bedding and joint inspection recorded with photos against chainage.
  • Utility clearance confirmation before shared backfill closes the box.
  • Compaction tests at road and pad crossings—soft spots here fail first under trucks.
  • Outlet and scour protection complete enough that temporary diversions can hand over.
Precast concrete box sections with rubber joint seals lowered onto aggregate bedding during stormwater construction NSW works beside an embankment
Bedding and joint seals need a recorded inspection before backfill hides them.

Procurement questions and lessons from drainage delivery

Ask tenderers to answer these in writing against your drawings. Brochure language about “full drainage capability” is not a method.

Lesson from delivery: orphan interfaces at kerbs, headwalls, and lot entries cause more post-handover call-backs than pipe diameter disputes. A stormwater team that brings an interface register into tender has usually paid for that lesson once already.

  • Where does water go while trenches are open, and who owns temporary diversions?
  • How are pit and grate levels tied to finished pavement or hardstand edges?
  • Which hold points and compaction tests close crossings before pavement layers start?
  • What stormwater handover records NSW packages can you show from a comparable site?
  • How do authority or council outlet interfaces get verified on site—not only on a long section?

Stormwater handover records and briefing NEXTGEN

Stormwater handover records NSW owners need should include as-built locations, invert levels, photographic evidence of bedding and joints, testing where specified, and an outstanding-works list tied to pits and outlets.

Weak records force owners to rediscover the network when landscaping, pavement upgrades, or authority audits arrive. Strong records make defect and maintenance decisions faster.

Browse related delivery evidence in the public utilities renewal program (representative scope). When drainage sits beside sealed access, bring roads division interfaces into the same inquiry. Then contact NEXTGEN with catchment plans, long sections, geotech notes, live-service information, and programme drivers.

Stormwater outlet and roadside swale discharging to a vegetated channel at dusk in NSW
Handover should prove outlets discharge where design intended—without ponding against finished surfaces.
FAQ

Frequently asked questions

What should project owners confirm with a stormwater drainage contractor in NSW?

Confirm catchments, temporary diversions, trench sequencing with other utilities, culvert and outlet details, pavement or pad interfaces, compaction at crossings, and handover records including as-builts and closed ITPs. Pipe schedules alone are not enough.

Is stormwater drainage the same scope as culvert installation?

No. Stormwater drainage covers the pit-and-pipe network and site water—catchments, diversions, trenches, outlets, and records. Culvert installation covers crossings under roads and access routes—barrels, cover depth, headwalls, scour protection, and the road interface. Many projects need both, so agree the hand-off pit or outlet level before either crew starts.

Which hold points matter most before backfill?

Invert and alignment, bedding and joints, utility clearances, compaction at crossings, and outlet readiness. Closing trenches without those gates creates expensive rediscovery under live traffic.

What should stormwater handover records include?

Expect as-built locations and invert levels, evidence of bedding and key joints, specified tests, photo records of outlets, and an outstanding-works register. That package lets owners maintain and upgrade the network without rediscovering it.
